Concrete Slab Cost in Australia: What Builders Should Expect

Published on:

April 2, 2025

Concrete slab cost is not a rate, it is a scope. Two quotes for the same slab area routinely land thousands apart because they cover different work, on different ground, with different reinforcement and different assumptions about who removes the spoil.

If you are pricing a slab against an allowance in a build budget, the useful question is not what the going rate is, it is which line items sit inside the number in front of you. This guide sets out the drivers that move slab pricing in Australia, what a quote should contain, and how to compare two that look nothing alike.

What actually determines what a concrete slab costs

Area is an input, not the answer. A slab is priced from a set of interacting variables, and changing any one of them changes the labour, the plant and the programme as well as the material volume.

The drivers that do the work are:

  • Slab type. A waffle pod raft, a stiffened raft, a suspended slab and a post-tensioned slab are different builds with different formwork, propping and labour profiles.
  • Site classification under AS 2870. Ground reactivity sets footing depth, edge beam design and reinforcement quantity before anyone prices concrete.
  • Slab thickness and edge beam design. Both change concrete volume and steel quantity, and thickenings are often where the volume actually goes.
  • Reinforcement schedule. Mesh grade, bar diameter, spacing and lap lengths come off the engineer's drawings, not off a rate card.
  • Concrete grade and volume. N20, N25 and N32 are not interchangeable, and grade is specified, not chosen for price.
  • Excavation, cut and fill, and spoil removal. Disposal is a haulage and tipping cost that scales with how much material leaves site and what it is classified as.
  • Site access and placement method. Direct chute, line pump and boom pump are three different cost positions, and standing time is real money.
  • Formwork and finish. Set-up, stripping and the specified finish all carry labour.
  • Programme and sequencing. Pours that must be broken into stages carry repeat mobilisation.

Every one of these is set by the drawings and the site, which is why a per square metre figure quoted without the drawings tells you almost nothing.

Slab type is the biggest single cost variable

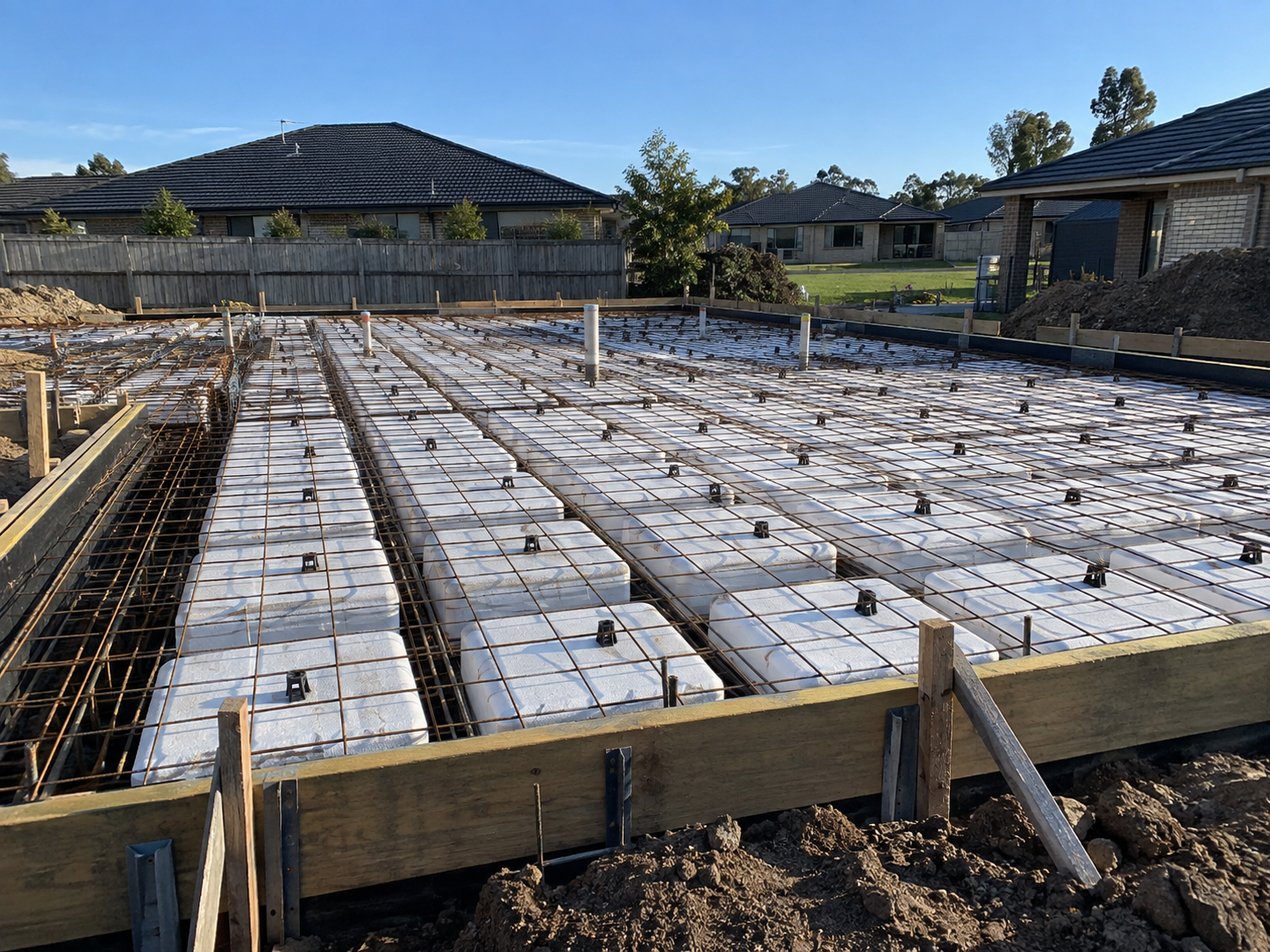

Waffle pod raft slab with pods and reinforcing mesh ready for concrete

Slab type moves the number further than any other decision, because it changes what has to be built to support the concrete rather than just how much concrete there is. A suspended slab needs formwork and propping that a slab on ground never requires. A post-tensioned slab brings specialist labour, stressing and grouting into a programme that a conventionally reinforced slab does not have.

Slab Type Typical Application What Drives Its Cost Up What Drives Its Cost Down Relative Cost Position
Slab on ground Sheds, garages, industrial floors, simple residential footprints on stable ground Deep thickenings, poor subgrade requiring imported fill, saw cutting and joint detailing Flat sites, uncomplicated shape, minimal edge beams, straightforward access The baseline the other types are measured against
Waffle pod raft Volume residential on reactive sites where the design suits a slab above ground level Pod supply and set-out labour, rib reinforcement, additional concrete in the ribs Little to no excavation, fast set-out on flat ground, minimal spoil to remove Broadly comparable to slab on ground on a flat, low-reactivity site, and often cheaper than a stiffened raft on a reactive one
Stiffened raft Residential and light commercial on reactive clay where beams need to be cut into the ground Beam excavation, higher steel quantity in beams, spoil removal, deeper beams on higher site classes Low reactivity classification, level site, shallow beam depths Higher than a waffle pod on the same site once beam excavation and spoil are counted
Suspended slab Upper floors, basements, podium decks, split-level construction Formwork and propping hire and labour, back-propping periods holding the programme, crane or pump access, higher reinforcement density Repetition across floors, regular grid, straightforward crane access Substantially higher than any slab on ground, because the temporary works are a build in themselves
Post-tensioned slab Long spans, transfer decks, car parks, apartment and basement structures Specialist stressing labour, ducts, anchors and grouting, staged stressing in the programme, engineering coordination Reduced concrete depth and reduced conventional steel, longer spans meaning fewer columns and footings below Higher rate per square metre than a conventional slab, but frequently a lower whole-structure cost because of what it removes elsewhere

The last row is the one builders most often price incorrectly. A post-tensioned slab compared as a slab looks expensive. Compared as a structural system, including the columns, footings and floor-to-floor height it saves, it often does not. If that comparison is live on your project, post-tensioned slab construction sets out what the work actually involves on site.

What does a house slab cost?

A house slab is priced the same way as any other slab, from the drawings and the site classification, but the variable that dominates on residential work is ground reactivity rather than area. A single-storey house footprint on a Class A or Class S site and the identical footprint on a Class H2 site are two different slabs. The second one carries deeper beams, more steel, more excavation and more spoil, and none of that is visible in a per square metre rate.

For builders pricing residential slabs, the questions that actually move the number are:

  • What class did the soil report return, and does the slab design match it? A quote priced off an early concept plan before classification is an allowance, not a price.
  • Waffle pod or stiffened raft? The engineer's choice changes excavation volume, spoil, steel quantity and set-out labour in opposite directions.
  • How much cut and fill does the pad need? Sloping blocks generate retained edges, benching and imported fill, and on Melbourne's clay that work is frequently larger than the slab itself.
  • Are edge beams, thickenings and step-downs to wet areas and garages priced in? These are a routine source of variations.
  • Is the driveway, porch or alfresco slab in the same quote? Often it is not, and the assumption is rarely stated.

Because those variables swing so widely, no honest single figure exists for a house slab in Australia. Published rates move with region, site class, design and the state of the subcontract market, and a rate that was accurate for one block in Preston is not transferable to the next street. Price a house slab from the soil report, the engineer's drawings and a scoped quote, in that order.

Site classification and ground conditions

Site classification under AS 2870, the Australian Standard for residential slabs and footings, is the driver that moves residential slab cost most across Melbourne and much of Victoria, where reactive clay soils are common, and it is the one that almost never appears in published cost guides. Classification describes how much the ground is expected to move with seasonal moisture change, and the slab is then designed to tolerate that movement.

The classes run from stable to problem ground:

  • Class A. Most sand and rock sites, little or no ground movement expected.
  • Class S. Slightly reactive clay, slight movement.
  • Class M. Moderately reactive clay or silt, moderate movement.
  • Class H1 and H2. Highly reactive clay, high and very high movement respectively.
  • Class E. Extremely reactive.
  • Class P. Problem sites, including fill, soft soils, mine subsidence and sites where normal classification does not apply.

Moving up that scale increases beam depth, beam width and reinforcement, which increases excavation, spoil, steel and concrete volume together. It can also pull the design toward a different slab type entirely. Class P sites are the outlier, because they are not a class so much as a referral back to the engineer, and they can carry piers, deep footings or ground improvement that sit well outside a normal slab scope.

Two practical consequences for a builder. First, a slab price given before the soil report exists is an allowance carrying a variation waiting inside it. Second, classification interacts directly with slab thickness and with the reinforcement schedule, so a quote that shows a thickness but not the beam schedule is incomplete.

Site preparation, access and what they add

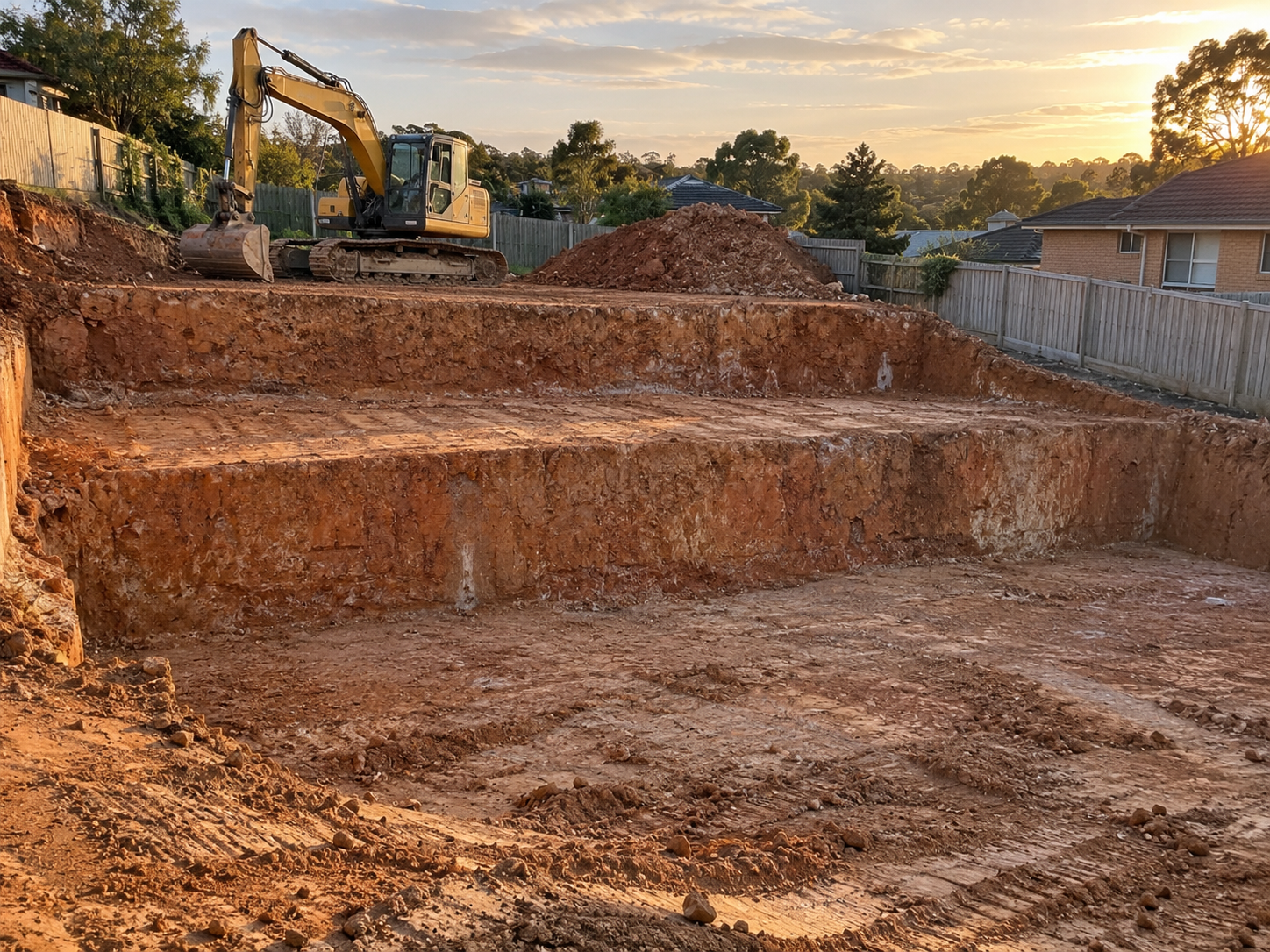

Benched and excavated building platform cut into clay on a sloping Melbourne site

Preparation is where slab quotes diverge most sharply, because it is the part of the work that varies with the block rather than the building. A level, dry, clear site with a wide crossover is a different job to a sloping clay block with a single-lane frontage.

The preparation scope covers site set-out and survey, stripping topsoil, cut and fill to level the pad, benching on sloping ground, excavation for beams and thickenings, compaction of fill in layers, and laying the vapour barrier.

On a stepped or sloping block, site benching and excavation can be a larger line item than the concrete, and spoil disposal is priced by volume and by what the material is classified as, which is a cost that has nothing to do with the slab design at all. Access decides the placement method, and the placement method has its own cost:

  • Direct chute from the agitator. Cheapest, and only available where the truck can get within reach of the pour.
  • Line pump. Used where the truck cannot reach but the distance and height are modest. Set-up and clean-out both take time.
  • Boom pump. Needed for reach over obstacles, into basements or across a site. Priced on hire plus standing time, so a pour that stalls costs money while nothing is being placed.
  • Restricted frontage, narrow streets and shared access. These drive traffic management, permits and smaller loads, which means more deliveries for the same volume.
  • Steep or unstable ground. Adds temporary access, hardstand and sometimes a crane.

Standing time is the item builders most often leave out of their own comparison. A pump held up by a late steel inspection or an unprepared pad is charged whether concrete moves or not.

What a slab quote should include, and what it usually does not

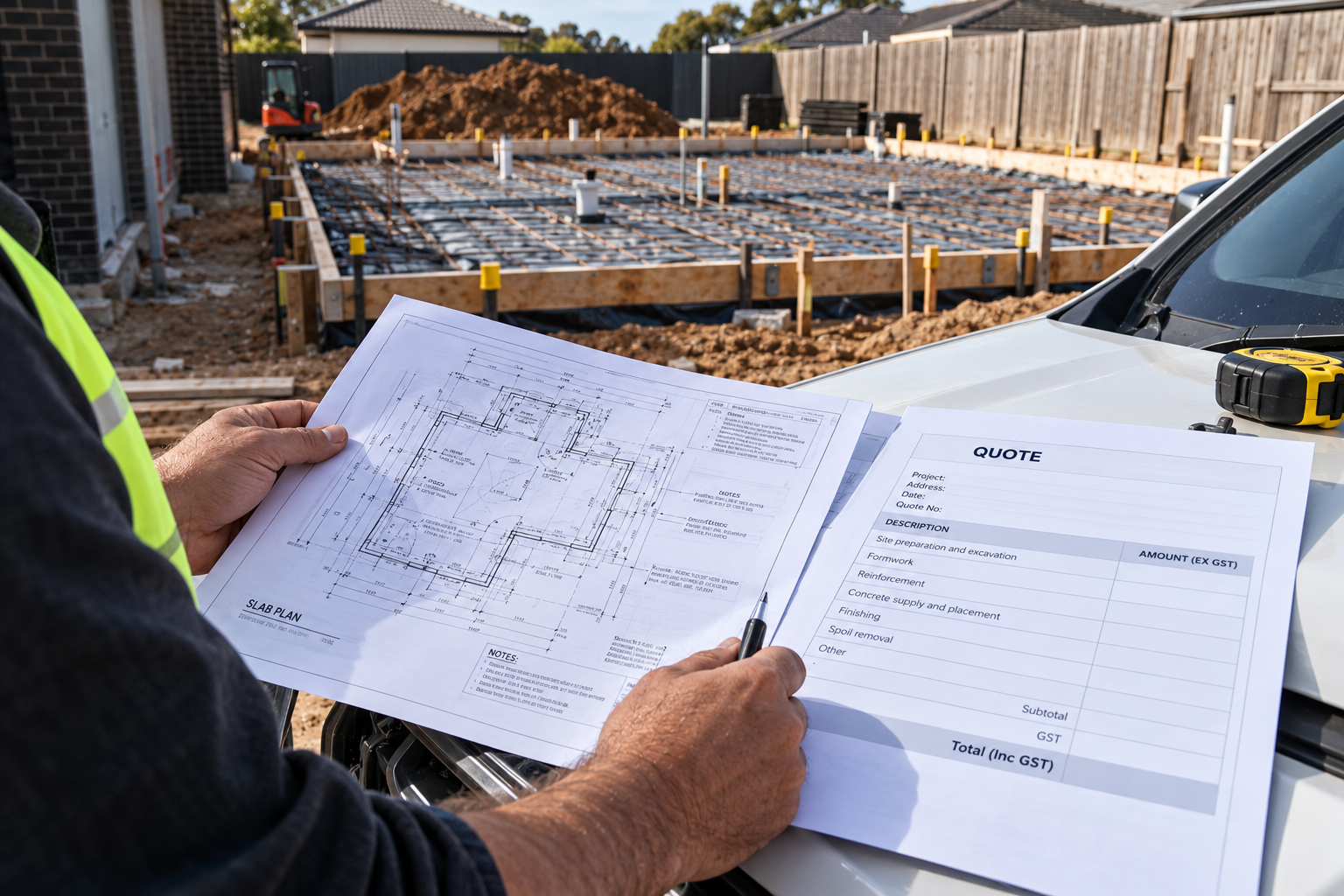

Builder comparing a concrete slab quote against structural drawings on site

Most slab quotes are compared on the total, when the difference between them is almost always in the inclusions. Work through the line items below against any quote before you accept it.

Line Item Usually Included Often Excluded or a Provisional Sum What to Ask Before You Accept the Quote
Set-out and survey Sometimes, and often assumed to be the builder's Frequently the builder's responsibility Who sets out, and against whose datum?
Bulk excavation and cut to level Sometimes, more often a separate trade Commonly excluded on sloping sites Is the pad assumed level, and at what reduced level?
Beam and thickening excavation Usually Rarely, but depth is often assumed Which site class and beam schedule has been priced?
Spoil removal and disposal Sometimes Very often a provisional sum by the cubic metre Is spoil removed or left on site, and at what assumed volume and classification?
Imported fill and compaction Rarely Commonly a provisional sum What fill depth is allowed for, and who tests compaction?
Vapour barrier and damp-proof membrane Usually Occasionally Is the membrane grade specified, and who taps and tapes penetrations?
Formwork supply, erection and stripping Usually for slab on ground Suspended slab formwork is often a separate package Is propping and back-propping in this price, and for how long?
Reinforcement supply Usually Sometimes a supply-only or schedule allowance Does the quoted steel match the engineer's schedule exactly?
Reinforcement placement and inspection hold Usually Rarely Who calls the inspection, and who wears the standing time if it fails?
Concrete supply Usually Occasionally supply by others Which grade, slump and additives, and is the volume from the drawings or an estimate?
Pump hire and standing time Rarely priced in full Very often excluded or capped Is the pump type nominated, and how is standing time charged?
Placement, screeding and finishing Usually Specialist finishes almost always extra Which finish is specified, and does that match the floor covering?
Curing and protection Usually Sometimes What curing method, and is wet-weather protection allowed for?
Saw cutting and joints Sometimes Often separate Are control joints in the quote and set out on the drawings?
Site clean-up and waste removal Sometimes Frequently the builder's Who removes the formwork waste and washout?

Two quotes that differ by a meaningful margin usually differ on spoil, pump and fill. Normalise those three before you conclude anything about the rest.

Why quotes move, and how to read a cost that is a year old

Slab pricing moves with the cost of what goes into it and with how busy the subcontract market is, which is why an undated figure is close to useless. According to the Australian Bureau of Statistics Producer Price Indexes, input prices to house construction rose 2.1 per cent in the June quarter 2026 and 3.8 per cent over the year, while output prices for house construction rose 2.0 per cent for the quarter and 5.9 per cent over the year.

Inputs and outputs are not moving at the same pace, which tells you margin and labour are doing as much work in the number as materials are.Pipeline matters too, because subcontract pricing responds to how much work is chasing the same crews.

ABS Building Approvals for July 2026 recorded total dwellings approved falling 3.6 per cent to 17,687 and the value of residential building falling 4.9 per cent to $11.26 billion, seasonally adjusted. Approvals feed the slab pipeline several months later, so a soft month reads through to concrete crews with a lag rather than immediately.

The practical rule: treat any slab figure without a reference period as unusable, and treat one older than two quarters as needing re-pricing before it goes into a tender.

How to compare two slab quotes

  1. Normalise the scope before you compare the totals. Use the table above and mark every line as included, excluded or provisional on both quotes. Compare the two adjusted totals, not the two headline numbers.
  2. Check the reinforcement against the engineer's schedule. Mesh grade, bar size, spacing, cover and lap lengths. A cheaper quote that has priced lighter steel is not cheaper, it is non-compliant.
  3. Check the concrete grade and volume. Confirm the specified grade, and confirm whether the volume came off the drawings or off an estimate. Volume estimated low is a variation on pour day.
  4. Identify every provisional sum and prime cost item. Spoil, fill and pump hire are the usual three. Ask what quantity each provisional sum assumes, because that assumption is the real price.
  5. Establish who carries spoil, pump and standing time. These three cause most slab variations and most of the arguments about them.
  6. Confirm the site classification each quote priced. If one priced Class M and the other Class H1, you are not comparing quotes, you are comparing sites that do not exist.
  7. Confirm the programme. Staged pours mean repeat mobilisation, and a quote assuming one pour where the programme needs three is understated.

Doing this properly usually takes half an hour and routinely finds more money than any negotiation on rate will.

Where to go deeper

Get a slab price from Urban Pour

Price a slab from the soil report and the engineer's drawings, then compare quotes on scope rather than on total. Once you know which line items you need covered, the number stops being a guess.

Urban Pour handles excavation, formwork, reinforcement and the pour as one scope in Melbourne, which is exactly the boundary most slab variations sit on. Send through your drawings and site classification and talk to Urban Pour about your slab.

Frequently asked questions

1. What determines the cost of a concrete slab in Australia?

Slab type, site classification under AS 2870, thickness and edge beam design, the reinforcement schedule, concrete grade and volume, excavation and spoil removal, site access and placement method, formwork and finish. Area sets the scale, but these variables set the price. Two slabs of identical area on different sites are genuinely different jobs.

2. Why do two quotes for the same slab area come back so differently?

Almost always because they include different work. Spoil removal, imported fill and pump hire are the three items most often excluded or carried as provisional sums, and any one of them can account for the whole gap. Mark every line item on both quotes as included, excluded or provisional before comparing totals.

3. Does slab thickness change the cost much?

Thickness changes concrete volume directly, and it usually comes with a heavier reinforcement schedule, so the two move together. On many slabs, though, more volume sits in the edge beams and thickenings than in the general slab depth. Price from the beam schedule as well as the nominal thickness.

4. How does site classification affect slab cost?

Higher reactivity classes require deeper and wider beams and more reinforcement to tolerate ground movement, which increases excavation, spoil, steel and concrete together. Class P sites are referred back to the engineer and can require piers or ground improvement outside a normal slab scope. Classification should be settled before a slab is priced.

5. Is a post-tensioned slab more expensive than a conventional slab?

Compared slab against slab, generally yes, because of stressing labour, ducts, anchors and grouting. Compared as a structural system it often is not, because reduced slab depth and longer spans can remove columns, footings and floor-to-floor height. Assess it at whole-structure level, not by slab rate.

6. What is usually excluded from a concrete slab quote?

Most commonly spoil removal and disposal, imported fill and compaction, pump hire and standing time, bulk excavation to level on sloping sites, specialist finishes, saw cutting and final site clean-up. Set-out is frequently assumed to be the builder's. Ask which of these are excluded rather than assuming they are in.

7. concrete slab costs change much from year to year?

Yes. The Australian Bureau of Statistics reported input prices to house construction rising 3.8 per cent over the year to the June quarter 2026, with output prices up 5.9 per cent over the same period. Treat any slab figure without a reference period as unusable, and re-price anything older than two quarters.
