How Much Does Underpinning Cost in Australia?

Published on:

September 6, 2026

Underpinning work beneath a brick house with concrete piers and temporary supports along the exposed foundation.

Underpinning is not priced as a house. It is priced as a set of piers driven to a design depth under a specific set of site conditions, which is why two honest quotes for the same dwelling can sit a long way apart. Most of that gap is scope, not margin. This guide is written for builders, developers and site managers who are scoping underpinning, checking a subcontractor's number or defending a variation. It publishes no price, because no national underpinning cost figure survives contact with a real site. What it does explain is every driver that moves the number. To confirm: Urban Pour cost bands

The short answer: underpinning is priced per pier, not per house

Underpinning in Australia is priced per pier, not per house. A quote is built from the number of piers an engineer specifies, the depth each one must reach, the method chosen, and the access available to dig and pour. Change any one of those and the total moves.

The eight variables that build the number:

  • Pier count, set by the engineer's design, not by the floor area of the building
  • Pier depth, meaning depth to competent founding material, not a nominated figure
  • Method, whether mass concrete, screw piles, bored piers or resin injection
  • Access, including whether excavation is by hand or by machine
  • Engineering and geotechnical investigation, priced before the piers are
  • Building permit and building surveyor documentation
  • Protection work obligations to adjoining owners
  • Programme and sequencing, which cap how many piers can be worked at once

Figures move with site and scope, and any number quoted without a drawing behind it is a guess. To confirm: Urban Pour cost bands

What underpinning is, and when a builder specifies it

Underpinning extends or deepens an existing footing system so load transfers to material capable of carrying it. The existing footing is not replaced. It is supported from below by new structural elements, usually piers, reaching past the zone of moisture-driven ground movement.

Three scopes are routinely confused, and they price very differently:

  • Underpinning deepens or augments the existing footing system with new structural support. It is engineer-designed and permit-triggering.
  • Reblocking or restumping replaces the stumps under a suspended timber floor. It does nothing for a failing strip footing.
  • New-build piling installs foundations into an open site, with no existing structure to protect, sequence around or prop.

A builder specifies underpinning when the ground under an existing footing stops doing its job. The usual triggers are differential settlement, excavation adjacent to or beneath the structure, a change of load such as an added storey, footings undermined by erosion or services failure, and sustained soil moisture change. CSIRO's Foundation Maintenance and Footing Performance guide, 2024 edition, notes that remediation of footings and foundations is generally the realm of a specialist consultant.

The cost drivers that actually move an underpinning quote

Narrow side setback restricting machine access on an underpinning site

Every underpinning number is assembled from the same drivers. Knowing which ones your site aggravates tells you where a quote will land.

Soil class and site classification

Reactive clay is why most Australian underpinning work exists. Clays absorb water and swell, then shrink as they dry, and CSIRO's 2024 guide explains that this movement occurs unevenly across a building's foundation soil because compaction and moisture content vary from point to point. A rigid building bridging uneven movement is what cracks.

Sites are classified by how much movement that reactivity can produce:

  • S, slightly reactive
  • M, moderately reactive
  • H1, highly reactive
  • H2, highly reactive, very high movement
  • E, extremely reactive

Classification is a cost input in its own right. Geotechnical investigation is priced and completed before pier design is settled, and a more reactive class generally pushes design depth and pier numbers up.

Depth to competent founding material

Depth is the single largest driver of cost per pier. It sets excavation volume, spoil handling, propping duration, concrete volume and the labour hours each pit or shaft consumes. It compounds too, because a pier taken deeper costs more per metre at the bottom than at the top as conditions get harder.

It is also the most common source of variations. Where a subcontractor prices an assumed depth rather than a design depth confirmed by the geotechnical report, the shortfall lands as a variation once the first pits are open.

Number, spacing and sequencing of piers

Pier spacing is engineer-designed, not a productivity decision. Underpinning runs in stages so only a limited length of footing is unsupported at once, and that constraint governs how much of the job can run in parallel.

The typical sequence:

  1. Excavate the first set of non-adjacent pits or shafts to design depth
  2. Prop and support the exposed footing
  3. Place reinforcement and concrete, then allow the required strength gain
  4. Dry-pack or otherwise transfer load between the new element and the existing footing
  5. Backfill, then move to the next set in the sequence

Staging is why the programme runs longer than the pier count suggests, and programme is cost.

Access, excavation and spoil

Access decides whether the work is machine-assisted or hand-dug. A rear corner reachable only down a tight side setback, a pier line under a floor inside an occupied dwelling, or a site with no hardstand for a spoil bin will each move labour hours sharply.

The variables worth pricing explicitly:

  • Hand excavation versus machine excavation, and the changeover point between them
  • Narrow side setbacks, low headroom and working beneath a suspended floor
  • Distance from the pier line to the spoil bin, and whether spoil is barrowed
  • Propping and temporary works needed to keep the structure and excavation safe
  • Whether the building is occupied during the works

Where bulk earthworks or benching are needed before the pier line can be reached, site benching and excavation should be priced as its own item rather than absorbed into a pier rate.

Engineering, permits and building surveyor documentation

Underpinning in Victoria requires a building permit. The Victorian Building Authority's Building Practice Note BP 01, When is a building permit required, dated 20 December 2023, lists "underpinning or replacement of footings" as an exclusion from both the repair, renewal or maintenance exemption and the alterations exemption. Work of this kind cannot be treated as exempt.

The cost consequences follow. Engineer design and inspection, surveyor fees, permit fees and mandatory inspection holds are real line items, and holds consume programme. A quote carrying none of them has excluded them or assumed the builder carries them, and that difference is worth confirming in writing.

Protection work and adjoining owners

On constrained urban sites, obligations to adjoining owners frequently move the number more than the piers do. Victoria treats protection work as a defined regulatory step with its own documentation standard: the Building and Plumbing Commission's approved statement on protection work, version 2.0, published 23 June 2021, sets out the required format and information for documenting protection work proposals, including how adjoining properties are affected.

That documentation takes engineering input, survey and time, and notification sits on the critical path. Where a pier line runs close to a boundary, the zone of influence reaches a neighbour's footing and the scope grows accordingly.

Method selected

Method is chosen by ground conditions and access, and it changes the shape of the cost as well as its size. Mass concrete is labour-heavy and depth-limited. Screw piles are fast where a machine can reach and the ground accepts them. Resin injection is minimally disruptive but creates no structural pier. Where the design calls for deeper, higher-capacity support, solutions of the same family as bored piers and piling become appropriate.

Programme risk, weather and latent conditions

Latent conditions are why underpinning contracts get argued about. Rock at depth, groundwater in an open pit, an unrecorded service on the pier line, or a footing worse than assumed will each stop the sequence.

The recurring risks:

  • Rock or refusal at depth, changing method and productivity
  • Groundwater requiring dewatering and affecting the pour
  • Unidentified sewer, water, gas or electrical services on the pier line
  • Existing footings found unreinforced, cracked or shallower than recorded
  • Wet weather, which halts open excavation adjacent to a structure

How these are allocated between builder and subcontractor is a contract decision, and it should be visible in the quote.

Underpinning methods compared

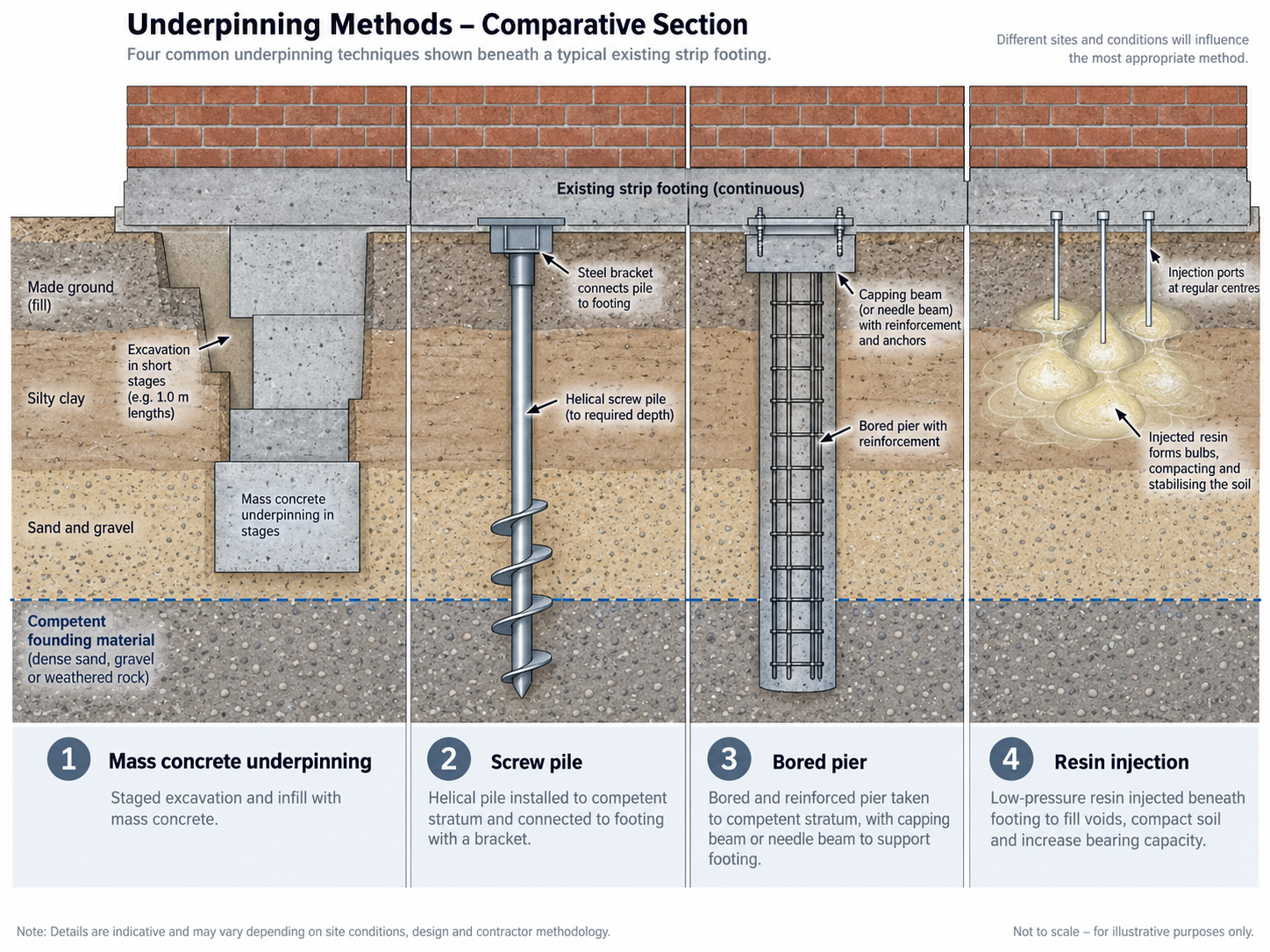

Cross-section diagram comparing mass concrete, screw pile, bored pier and resin injection underpinning
Method How It Works Site Conditions That Suit It What Drives Its Cost Main Limitations
Mass concrete underpinning Pits are excavated in sequence beneath the footing and filled with concrete, transferring load to deeper material Shallow to moderate depths, ground that stands up in a short excavation, restricted access where hand digging is the only option Depth, pit count, hand excavation hours, propping duration, sequencing constraints Labour intensive, depth-limited, slow, poor fit for very deep founding material
Screw piles Helical steel piles are turned into the ground and connected to the footing with brackets or needle beams Machine access, softer soils, projects where programme matters and disruption must be limited Pile length, machine access and set-up, bracket and needle beam detailing, torque requirements Obstructions and rock cause refusal, needs headroom and access, connection detail governs capacity
Bored piers Reinforced concrete shafts are drilled to design depth and tied into the footing via a capping or needle beam Deeper competent founding material, reactive clay sites, higher structural loads Depth, shaft diameter, reinforcement, rig access and set-up, spoil volume and removal Requires rig access and groundwater management, larger footprint than hand methods
Resin injection Structural resin is injected into the soil to fill voids and densify ground beneath the footing Settlement in loose or void-affected ground, occupied buildings where disruption must be minimal Resin volume, number of injection points, level monitoring during injection Creates no structural pier, unsuitable for many deep-founding and highly reactive situations, harder to verify

Cost bands for any of these methods depend entirely on the site and the engineer's design. To confirm: Urban Pour cost bands

What sits inside an underpinning quote, and what usually sits outside

Two quotes become comparable only once you know what each contains. This is where the variance lives.

Commonly Included in an Underpinning Price Commonly Excluded, Provisional or Assumed
Excavation of the pier line to the design depth stated in the quote Rock excavation and refusal allowances beyond the quoted depth
Supply and placement of concrete and reinforcement to the piers Groundwater, dewatering and pumping
Propping and temporary works to the works area Relocation or protection of sewer, water, gas and electrical services
Spoil removal from the immediate works area Landscaping, paving, decking and driveway reinstatement
Backfill and compaction to the excavated pits Cracking repair, rendering, cornice and cosmetic making good
Site establishment, plant and traffic management as stated Geotechnical investigation, where the builder or owner commissions it
Structural engineer design, where the subcontractor engages the engineer Building permit and building surveyor fees
Protection work documentation, where nominated in the scope Protection work to adjoining property, where not nominated

The exclusion column is the lesson: a lower number is often a narrower scope. Rock allowances, service relocation, reinstatement and permit fees do not disappear because a quote leaves them out.

How to compare two underpinning quotes properly

Checklist graphic for comparing two underpinning quotes on the same basis

Run both quotes through the same eight questions before comparing totals.

  1. Are both priced against the same engineer's drawing? Different pier counts and depths make the totals meaningless side by side.
  2. Is depth fixed or rate-adjusted? Establish the rate per additional metre and the point at which it applies.
  3. Who carries latent conditions? Rock, groundwater and unrecorded services need a named owner before work starts.
  4. Are engineering, permit and surveyor fees in or out? Confirm each separately, not as one line.
  5. What is the reinstatement scope? Backfill is not the same as restoring paving, landscaping or internal finishes.
  6. Is protection work documentation included, and who prepares it? On boundary-adjacent pier lines this is not optional.
  7. What sequencing assumption sits behind the programme? A quote assuming simultaneous pier gangs will not survive a staged engineering constraint.
  8. What insurances are held, and do they cover works adjacent to an adjoining property? Ask for currency of cover, not a statement that it exists.

To confirm: Urban Pour cost bands

Why published underpinning prices date so quickly

Every price range published online carries an expiry date it rarely displays. The Australian Bureau of Statistics reported in Producer Price Indexes, Australia, June 2026 quarter that building construction output prices rose 1.4 per cent, house construction output prices rose 2.0 per cent, and input prices to house construction rose 2.1 per cent in that quarter alone. Those are general construction index movements, not underpinning prices, but they show how fast the base under any quoted figure shifts.

The working rule: never accept a cost figure that does not carry its source and its date in the same sentence. A range published two years ago, with no stated scope, classification or design depth behind it, gives you nothing to price against.

Alternatives to underpinning, and when they are the cheaper call

Underpinning is sometimes the wrong answer. Where movement is driven by a fixable moisture problem rather than an inadequate footing, treating the cause is cheaper and lasts longer. CSIRO's 2024 guide is explicit that clay soils move with water, so a leaking sewer, a blocked stormwater line, poor surface fall or a badly placed tree can produce cracking no pier will resolve while the cause remains.

Options worth assessing before committing to a full scope:

  • Drainage and plumbing rectification, including stormwater fall, subsoil drainage and repair of leaking services
  • Moisture management around the perimeter, including vegetation and irrigation control
  • Monitoring before committing, using level surveys over a period to establish whether movement is active or historical
  • Partial rather than full underpinning, where the engineer isolates movement to one elevation
  • New piled footings as part of a rebuild, where the works already involve major structural change

Where the structure above is being replaced or extended rather than repaired, the comparison shifts again. New work is founded correctly from the start, and decisions about footing and slab design, including concrete slab thickness, are made on the drawing board rather than retrofitted underground. The same applies where excavation is planned beneath or beside an existing structure, as in residential basement construction, where retention is designed in rather than added later.

Talk to the Urban Pour team about your foundation scope

Getting a foundation number right starts with the ground investigation and the engineer's drawing, not with a rate off a website. Urban Pour works in structural concrete across Melbourne, including piling and bored piers, benching and excavation, in-situ walls, capping beams and sprayed concrete for retention and slope stabilisation. If you are scoping deep foundation work and want the drivers priced properly, talk to the Urban Pour team with your drawings in hand.

Frequently asked questions

1. How much does underpinning cost in Australia?

There is no reliable national figure. Underpinning is priced per pier, and the total is built from pier count, design depth, method, access, engineering, permits, protection work and programme. Figures move with site and scope, so any quote must be read against the engineer's drawing it was priced from. To confirm: Urban Pour cost bands

2. What are the disadvantages of underpinning?

It is disruptive, slow and staged by necessity, because only a limited length of footing can be unsupported at once. It requires a permit, engineering design and inspections in Victoria, and carries real latent condition risk from rock, groundwater and unrecorded services. It also treats the footing, not the moisture cause behind the movement.

3. What are the alternatives to underpinning?

Drainage and plumbing rectification, perimeter moisture management, vegetation control, level monitoring before committing, partial rather than full underpinning, and new piled footings where a rebuild is already planned. Where movement is driven by a fixable water problem, addressing the cause is usually cheaper and more durable than adding piers.

4. Do I need a structural engineer for underpinning?

Yes. Pier count, spacing, depth and the connection detail to the existing footing are engineering decisions, and the sequencing that keeps the structure stable is designed rather than improvised. A building surveyor requires engineering documentation before issuing a permit, and inspections are held against that design.

5. Do you need a building permit for underpinning in Victoria?

Yes. The Victorian Building Authority's Building Practice Note BP 01, dated 20 December 2023, lists "underpinning or replacement of footings" as an exclusion from both the repair, renewal or maintenance exemption and the alterations exemption. Underpinning cannot be carried out as exempt work, and permit, surveyor and inspection costs form part of the real cost.

6. How long does underpinning take?

Longer than the pier count suggests. Staged excavation means only part of the pier line can be worked at once, and each stage needs propping, pouring and strength gain before the next begins. Permit approval, engineering documentation and protection work notification all sit ahead of the first excavation.

7. Is underpinning the same as reblocking or restumping?

No. Reblocking or restumping replaces the stumps supporting a suspended timber floor. Underpinning deepens or augments the footing system itself so load is carried by more competent ground. They solve different structural problems, carry different documentation requirements, and are priced on entirely different bases.
