Site Cut vs Site Benching: What Melbourne Builders Need to Know

Published on:

September 18, 2026

Builders use the two terms as if they are interchangeable. They are not. A site cut is the result you are paying for. Benching is one of the methods used to get there safely when the ground will not stand up on its own.

A site cut is the excavation of a sloping or uneven block down to a level, compacted building pad at a set reduced level, ready for footings or a slab. Topsoil is stripped, material is cut to the engineer's levels, the subgrade is compacted, and the spoil is carted off site.

This guide separates the two properly, then covers the Victorian rules that catch Melbourne builders out.

What a site cut actually is

A site cut is an outcome, not a technique. The deliverable is a flat, stable platform at a nominated reduced level, within the engineer's tolerance.

Reduced level is the surveyed height the pad is cut to, measured against a fixed datum rather than existing ground. Get it wrong and you are out on every footing depth, step, finished floor level and drainage fall on the block.

A completed site cut normally includes:

  • Topsoil stripped, because organic material will not carry load
  • Bulk excavation to the reduced level across the pad footprint
  • Detailed excavation where footings, piers or service trenches go deeper
  • A compacted subgrade, not a scraped surface
  • Cut faces left stable, by controlled batter, benching or temporary support
  • Spoil removed and legally disposed of, classified before it leaves
  • Levels confirmed against the engineered drawings before handover

On a flat block in sand that is straightforward earthworks. On a sloping block in reactive clay, which describes much of Melbourne's north and east, the cut face becomes the problem.

What site benching is, and why it is not the same thing

Benching is a method. Instead of leaving one tall face where the cut meets higher ground, the excavation is stepped down in horizontal platforms so no single face carries its full height. It suits slopes, deep cuts and soils that will not hold a clean face.

It is also a safety control, not a shaping preference. WorkSafe Victoria's compliance code for excavation, published 19 December 2019, deals with reducing the risk of ground collapse, and benching and battering sit there alongside shoring as recognised ways of doing it.

So the two are not peers. A site cut is what you end up with. Benching is one of the ways you get there and keep the face standing while you do. You can cut a site with no benching at all, and you can bench an excavation that produces no building pad.

For the benching side in depth, we have covered how site benching works on Melbourne blocks, and the difference between benching and grading is a different comparison again.

Site cut vs site benching, side by side

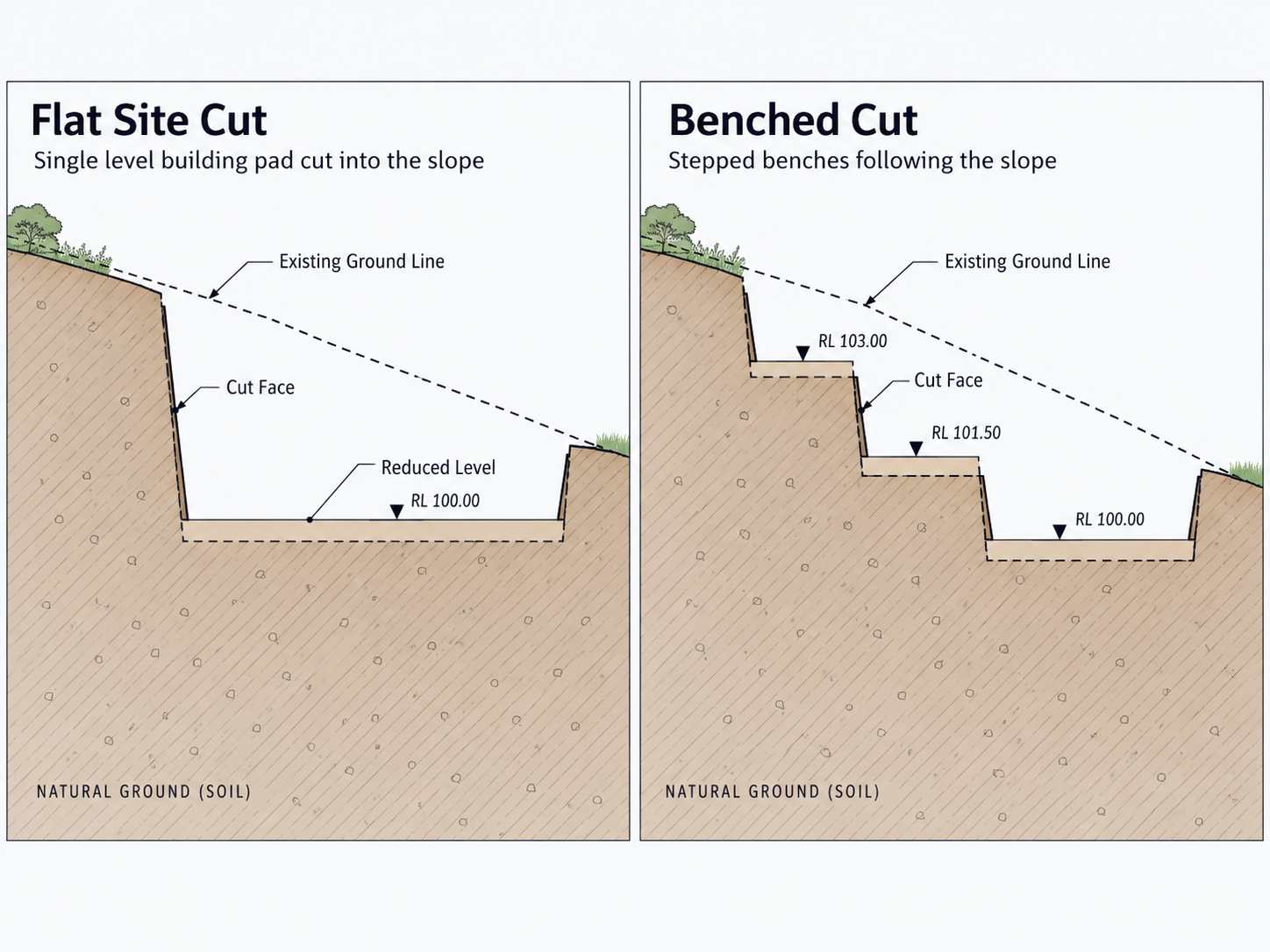

Cross-section diagram comparing a flat site cut with a benched cut on a sloping block
Comparison point Site cut Site benching
What it is Excavation of a block to a level building pad A stepped excavation method supporting the cut face
What it produces A compacted pad at a set reduced level Steps reducing the height of any single face
When it is used Wherever existing ground misses design levels Where slope, depth or unstable soil means one face will not hold
Typical ground Any, from sand to reactive clay to rock Sloping ground, deep cuts, soils prone to collapse
Plant used Excavator for bulk work, a bobcat for trimming The same plant, staged from the top down
Main risk if done badly Wrong reduced level, poor compaction, footings compromised Ground collapse, undermined ground, benches too narrow
Regulatory angle Sits under the building permit for the works it serves A recognised ground collapse control in Victoria
Who signs off Levels checked against engineered drawings by the surveyor Specified by the engineer, the duty holder responsible

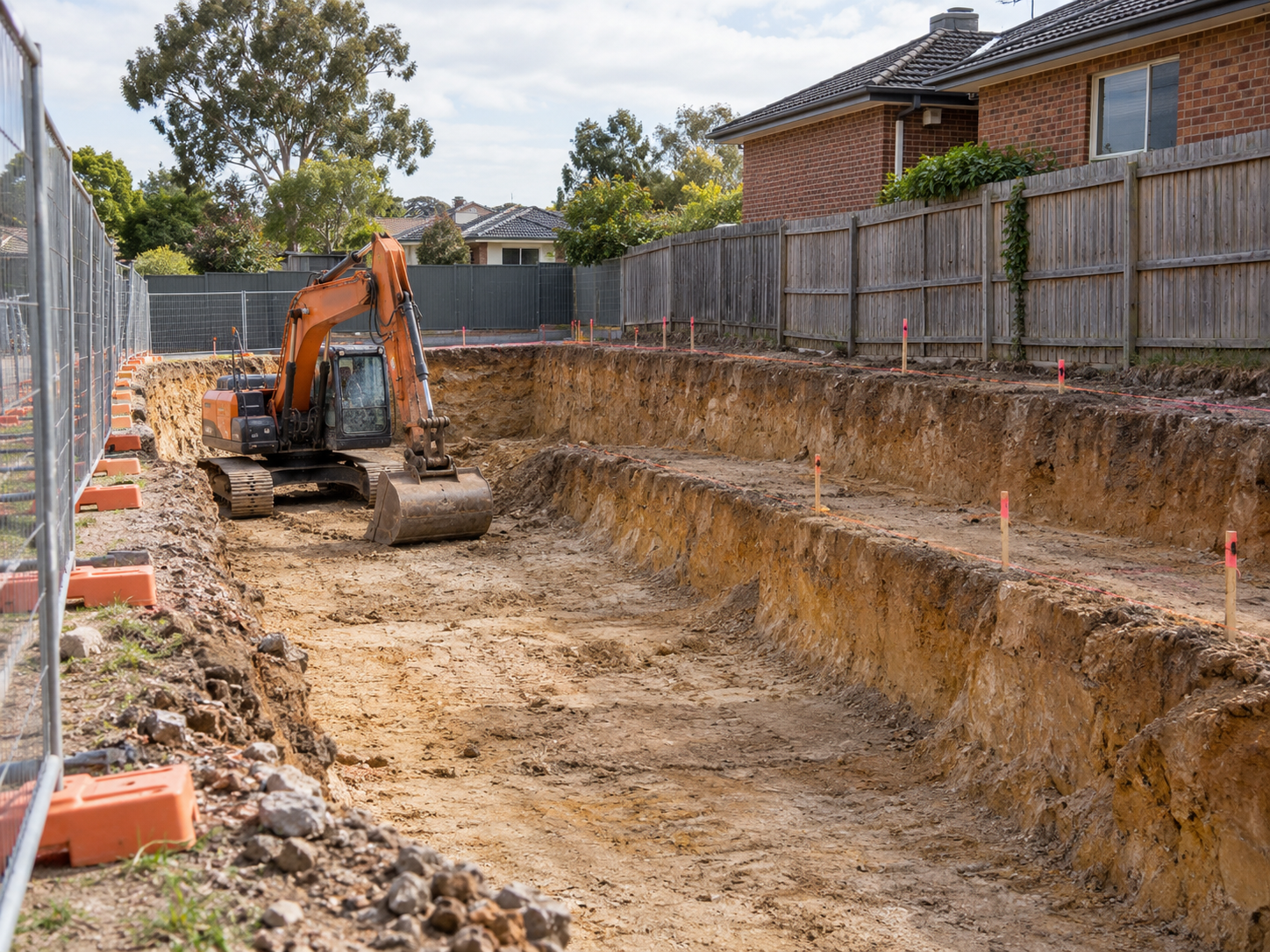

How a site cut is carried out on a Melbourne block

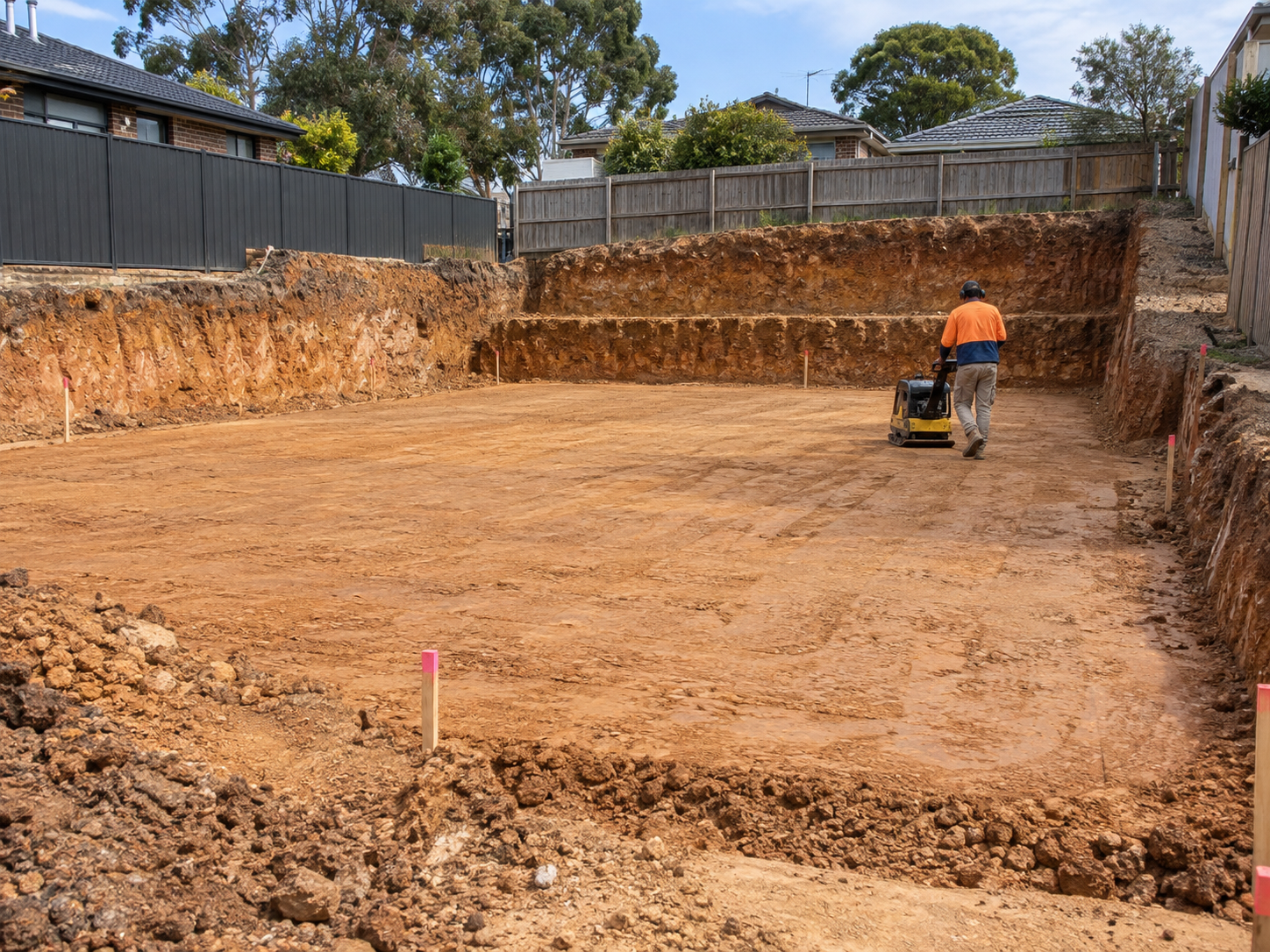

Subgrade being compacted on a completed site cut building pad in Melbourne
  1. Set-out and survey. The reduced level is established against a fixed datum. The step that costs most to correct later.
  2. Service location. Underground services located before anything is dug.
  3. Topsoil strip. Organic material off the footprint.
  4. Bulk excavation to the reduced level. The volume work, cutting the platform out of the block.
  5. Batter or bench the faces. Where slope or depth demands it, rather than leaving a face vertical.
  6. Detailed excavation. Footing trenches, pier positions and service runs to finished levels.
  7. Compaction and level check. Subgrade compacted, pad re-shot to confirm tolerance.
  8. Spoil removal. Material classified and carted to a legal receiver.
  9. Handover. The pad goes to the footing or slab crew.

Duration is governed by the block, not a standard programme. Volume, access, ground conditions, rock, service relocations and cartage distance all move it. Soil classification under AS 2870 and the geotechnical report tell you most of this before a machine arrives.

When benching is required instead of a straight cut

Straight cut when:

  • The block is close to level and the cut is shallow
  • The soil is stable and holds a face
  • The excavation is clear of boundaries and neighbouring structures
  • Nothing surcharges the ground above the cut face

Bench when:

  • The block falls enough that a single face gets tall
  • The cut is deep enough that a collapse would bury someone
  • The soil is loose, filled, saturated or otherwise unreliable
  • An adjoining structure, driveway or fence sits within the zone of influence
  • The face must stand before permanent retaining goes in

Temporary and permanent works are separate questions. Benching holds ground during construction; if the level change is staying, you still need retaining designed for it. Getting that sequencing wrong is one of the benching mistakes that cost builders money.

The Victorian rules that catch builders out

1. Excavation safety duties

Ground collapse is the hazard that defines this work. Safe Work Australia's model code puts it plainly: excavation collapses are dangerous and can happen quickly, which makes escape difficult. In Victoria the operative document is the WorkSafe compliance code, covering benching, battering and shoring as controls for reducing the risk of ground collapse. Choosing between them is an engineering decision, not a site preference.

2. Cutting near a boundary

The moment a cut approaches an adjoining property, the protection work regime applies. Protection work obligations for adjoining properties include underpinning of footings and shoring up, and the process has hard edges. The owner must serve notice on the adjoining owner, who has 14 days to respond or is deemed to have agreed. A condition survey must be prepared and signed as an agreed record. Insurance must cover the adjoining property, occupiers and the public for 12 months following completion. And a building permit may not be issued until the protection work process is completed to the approval of the building surveyor.

3. Where the spoil is allowed to go

Excavated soil is regulated material, not spare dirt. Under Victorian environment law, waste soil must be classified before it is transported. N120 is contaminated soil and is reportable priority waste. N122 is fill material, is not priority waste, and needs no permission to transport and no tracking. N123 is acid-sulfate soil and is priority waste. Soil sourced from contaminated land that is industrial waste must be classified as soon as practicable, and reportable priority waste soil must be tracked in Waste Tracker whenever it changes hands.

Two identical cuts on two identical blocks can land very differently, purely on what the soil turns out to be. If earthworks start next month, settle this first.

What drives the cost of a site cut

No honest figure exists without a site inspection. Here is what moves it:

  • Volume of material. Pad size against cut depth. More cubic metres, more machine hours, more trucks.
  • Ground conditions. Reactive clay, rock, uncontrolled fill or contaminated ground each change plant and method.
  • Spoil classification and disposal. Usually the largest swing factor, because the waste code decides where the material can legally go.
  • Site access and machine size. A tight block forces smaller plant and more truck movements.
  • Slope and ground support. Whether the job needs benching, battering, shoring or retaining.
  • Proximity to boundaries. Whether protection work obligations trigger, with the notice, survey and insurance that follow.
  • Services. Whether anything needs locating, protecting or relocating.
  • Scope. Bulk excavation only, or bulk plus detailed excavation.

What goes wrong, and what it costs you to fix

  • Cut to the wrong reduced level. Every footing depth, step and finished floor level downstream is wrong. Fixing it means re-cutting, or importing and compacting engineered fill.
  • Uncontrolled batter or an over-steep face. A collapse risk while people work below it, and a slumped face to clean up.
  • Undermining a boundary. Damage to a neighbour's ground or footing, with the protection work process running behind you rather than in front.
  • No drainage at the cut face. Water collects above the cut, softens the subgrade and loads whatever retaining follows.
  • Unclassified spoil. Material leaves site without a waste code and the disposal position gets unwound afterwards.
  • Poor compaction under the pad. Settlement shows up in the slab, not the dirt. Worth knowing what happens after the pad is cut before signing off the subgrade.

Getting your site cut right in Melbourne

Have these in hand before earthworks start:

  • A survey with the reduced level set out from a fixed datum
  • The geotechnical report and soil classification
  • Located and marked services
  • Engineered levels for the pad, footings and detailed excavation
  • Your boundary position, and the protection work answer if the cut goes near one
  • A spoil plan, with the waste classification and destination

Urban Pour is a Melbourne concrete contractor offering site benching and excavation alongside its concrete work, covering bulk earthmoving, detailed excavation for foundations, trenches and basements, underground structures, soil compaction and stabilisation, and rock removal.

Got a block that will not sit flat, or a cut heading towards a boundary? Talk to Urban Pour about your site and get the levels, ground support and spoil sorted before the machines turn up.

Frequently asked questions

1. What is a site cut?

A site cut is the excavation of a block down to a level, compacted building pad at a set reduced level. Topsoil is stripped, material cut to the engineer's levels, the subgrade compacted and the spoil carted away, ready for footings.

2. What is the difference between a site cut and benching?

A site cut is the outcome, a level pad at a nominated reduced level. Benching is one method of achieving and supporting that cut, stepping the excavation down so no single face carries its full height. It is also a recognised ground collapse control in Victoria.

3. How long does a site cut take?

It depends on the block, not a standard programme. Cut volume, site access, ground conditions, rock, service relocations and cartage distance all change the duration. A geotechnical report and accurate levels before you start are the best predictor of a clean run.

4. Do you need a permit for a site cut in Melbourne?

A site cut is usually carried out under the building permit for the work it prepares for, rather than a standalone earthworks permit. Where the cut approaches an adjoining property, the protection work process must be completed to the building surveyor's approval before a permit may be issued.

5. How much does a site cut cost?

There is no meaningful figure without a site inspection. Cost is driven by cut volume, ground conditions, spoil classification and disposal, access and plant size, whether benching or retaining is needed, and whether detailed excavation is included. Spoil is usually the largest variable.

6. What happens to the soil removed during a site cut?

It is classified before transport. Fill material coded N122 is not priority waste and needs no tracking. Contaminated soil coded N120 is reportable priority waste, and acid-sulfate soil coded N123 is priority waste. Reportable priority waste soil must be tracked in Waste Tracker whenever it changes hands.

7. Do you need a retaining wall after a site cut?

Often, yes. Benching and battering hold ground during construction, but they are temporary works. Where the cut creates a permanent level change the ground cannot hold at its natural angle, engineered retaining is required. Your engineer decides on cut height, soil and surcharge above the face.
